Roofing

State Farm Roof Approval After a Missed Policy Deadline

By Directorii  •  August 14, 2026  •  3 min
State Farm Roof Approval After a Missed Policy Deadline

A roof replacement approval can arrive after the policy period for collecting withheld depreciation has ended. Before authorizing work in that situation, ask State Farm in writing whether it will pay the remaining amount once the roof is complete.

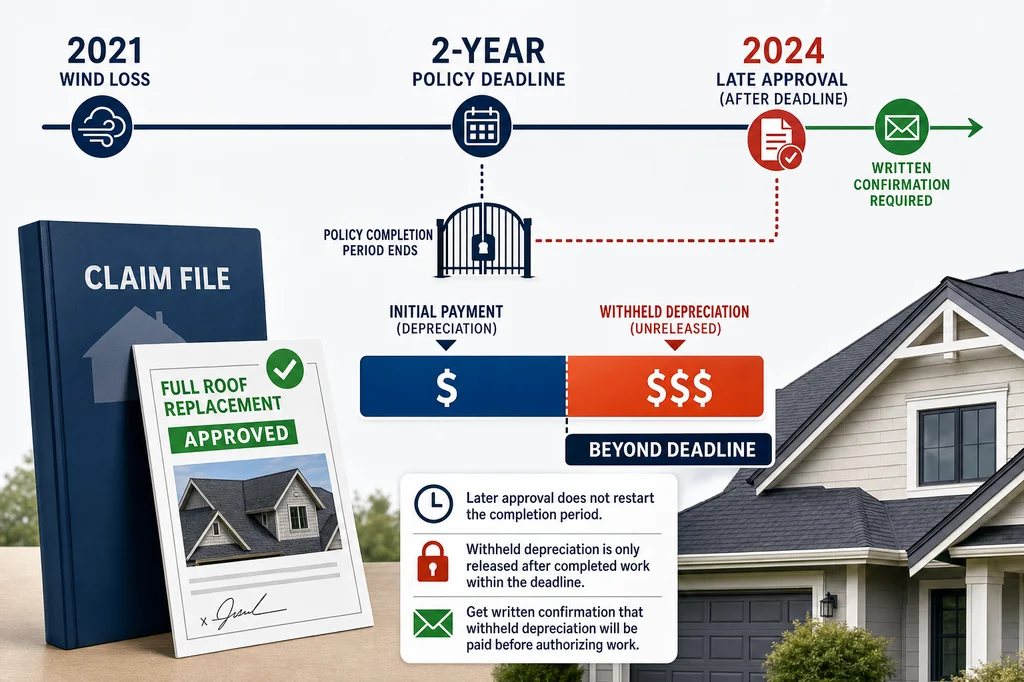

A 2021 wind claim left a $12,000 payment gap

One homeowner’s roof was damaged by wind in 2021. State Farm initially allowed repairs to 38 shingles, an amount below the deductible, and closed the claim. After a lengthy dispute, State Farm agreed in 2024 that the roof needed full replacement.

The roofer completed the replacement and submitted the requested documents. State Farm then declined to pay the full cost because the policy required the work to be completed within two years. The roofer said he was left with a $12,000 loss and did not seek that amount from the homeowner.

The issue was not whether the roof had eventually been approved. It was whether the remaining payment could still be collected after the completion period in the policy had passed.

What recoverable depreciation means in this situation

Recoverable depreciation is money withheld until covered work is completed. A replacement approval does not necessarily answer whether that withheld amount will be released after a deadline has passed.

Sam Cook, a public adjuster who works in nine states, said many policies provide one or two years from the storm date to recover depreciation. He said State Farm commonly uses two years in most of the states where he works. That is not a universal rule: the controlling language is in the homeowner’s own policy and claim documents.

For a delayed wind claim, compare the date of loss with the policy condition for completing work and recovering depreciation. Do not assume that a later supplement or replacement approval starts a new completion period.

Get the payment answer before the roof is scheduled

When an approval arrives late, the most important question is direct: if the replacement is completed now, will State Farm pay the withheld depreciation? Request the answer through email or the claim portal and keep it with the approval and contract.

  • Ask State Farm to identify the completion deadline it applies to your claim.
  • Ask whether the approved replacement will be paid in full after completion, including any withheld depreciation.
  • Ask which completion documents it requires before releasing the remaining payment.
  • Compare the money already issued with the contractor’s total price before work begins.

Cook’s point was that some carriers or adjusters may agree to pay outside their normal agreement when a delay created the problem, but that needs to be put in writing. A verbal assurance does not establish how the final payment will be handled.

Read the contract against the unpaid amount

The contract wording can determine who bears a shortfall. An insurance-proceeds contract may charge the amount the insurer pays, while another agreement may charge the amount approved for the roof. Those can produce different results when a roof is approved but part of the payment is withheld.

Before signing, identify the full contract price and what happens if withheld depreciation is not paid. If the deadline has passed and State Farm will not provide a clear written payment answer, do not treat the replacement as fully funded by the claim. Review unclear policy or contract language with qualified legal or licensed insurance guidance in your state.

A public adjuster does not replace deadline tracking

A public adjuster was involved in the wind claim, but the missed completion period still became central. Someone must track the loss date, the policy condition, and the carrier’s written payment commitment as the claim moves from repair scope to replacement approval.

A roofing contractor can provide a written scope and payment terms for the replacement. The insurance policy remains the homeowner’s contract with the carrier. Directorii lists verified contractors.

Find a verified roofing pro

Source: Roofers vs Insurance: 4 Court Battles, 4 Shocking Verdicts

FAQ

What is recoverable depreciation on a roof claim?

It is money withheld until covered repair or replacement work is completed. The policy may set conditions and a time period for collecting it.

Does a late State Farm roof approval restart the deadline?

Do not assume it does. In the wind-claim example, the replacement was approved years after the loss, while State Farm relied on a two-year completion condition. Check your own policy and obtain a written answer for your claim.

What should I ask State Farm before starting a late-approved replacement?

Ask whether it will pay the withheld depreciation after the work is completed, which deadline applies to your claim, and which documents it requires for final payment. Request the response in writing.

Why does the roofing contract matter if insurance approved the roof?

The contract may be based on insurance proceeds actually paid or on the amount approved for the roof. Those terms can matter if the carrier approves replacement but does not release all remaining funds.
